Skip to main content
Skip table of contents

Concept of Studio Environment

Overview

The Studio environment has been introduced to Eleveo WFM to facilitate forecasting and scheduling and provide additional flexibility. There is a Forecasting Studio and a Scheduling Studio, each permitting the creation of any number of drafts and then building production forecasts or schedules based on them.

  • A draft is an outline of a forecast/schedule. Multiple draft forecasts for the same time period can be created, each based on different historical data or containing a variety of adjustments. Similarly, more than one draft schedule can be created for the same time period.

  • Production forecasts/schedules are the final ones, used within a company. There can be only one production forecast for the time period, and this forecast is used to create a schedule. Similarly, each person can have only one production schedule assigned for the selected time range.

Forecasting Studio

The Forecasting Studio environment facilitates the configuration of any number of draft forecasts and allows for them to be applied to the production forecast. A production forecast can be considered as a long-term timeline. It is filled with blocks of time (time ranges) using the draft forecasts.

The benefits of draft forecasts include:

  • draft forecasts for different time periods can be based on different historical data

  • draft forecasts for one time period can be based on different historical data for comparison

To display all forecasts (draft and production), expand the Forecasting module within the navigation tree and click Studio. The Forecasting Studio screen will display.

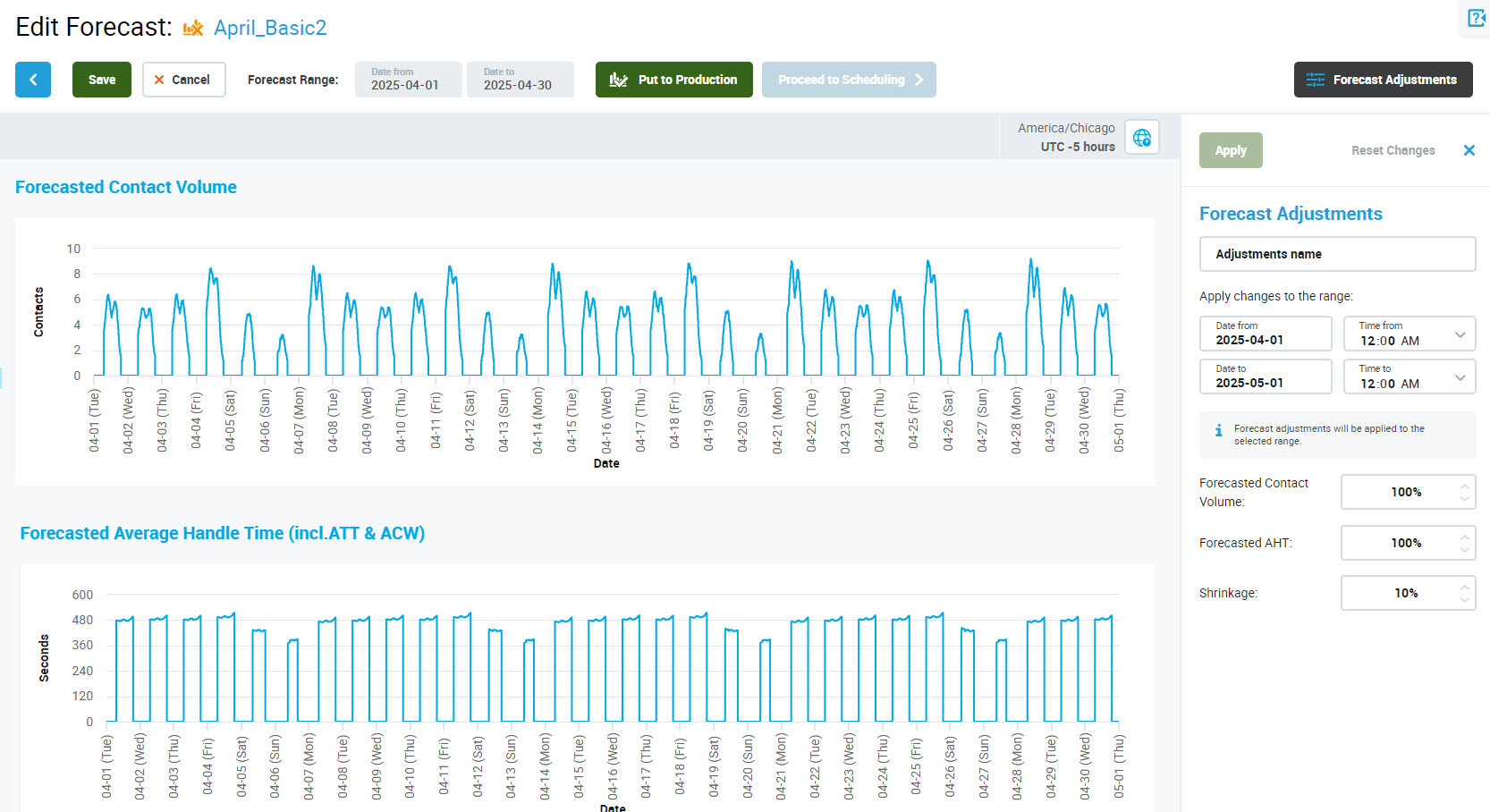

Click on the View option to display the details of a draft forecast. If you want to customize it by applying some adjustments, use the Edit option. The wizard also allows you to put the forecast straight into production.


Scheduling Studio

The Scheduling Studio environment facilitates the configuration of any number of draft schedules. Each new schedule is based on a production forecast and is limited by the selected time period and queue. Similarly to the production forecast, the production schedule is a long-term timeline. This timeline is filled with blocks of time (time ranges) using the draft schedules.

To display all existing schedules (draft and production), expand the Scheduling module within the navigation tree and click Studio. The Scheduling Studio screen will display.


Click on the View option to display the details of a draft schedule. If you want to modify it, use the Edit option.


The benefits of draft schedules include:

  • a new shorter schedule can be created to overwrite the current longer schedule (for example to create an exception from the schedule for one day)

  • different groups of people may be assigned for different time periods

  • two managers can create schedules for different periods independently and then apply them to the production schedule

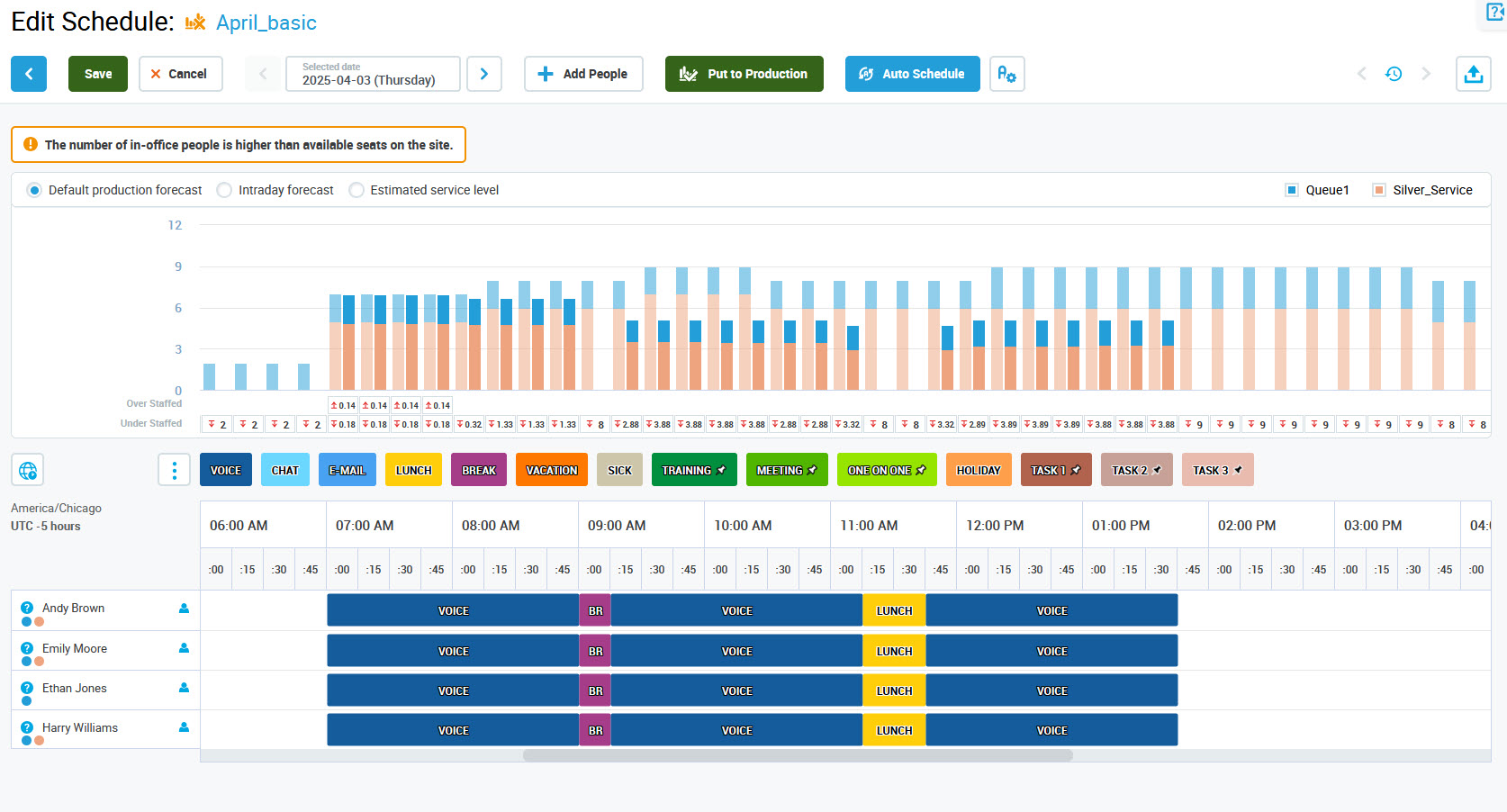

When a schedule is ready, it can be put into production, and as a result, it will be visible to all affected people. They can review it using the My Schedule screen and create requests (Vacation, Shift Swap) as needed. The status of the schedule (In Draft, In Production, or Auto Scheduling in progress) is displayed in the Status column:



There is only one production forecast and one production schedule for each queue for each day.

Examples

Examples of dependency between forecasts and schedules are covered by the below scenarios and presented on diagrams. Click on the links below to expand the examples.

Scenario A: A single forecast for a single schedule

Task: Create a single schedule using a single forecast.

Solution:

  1. Create a forecast “A 1 to 31/3” for Queue A for 1st to 31st March 2021 using historical data from 1st to 28th April 2017 and save it as a draft.

  2. Put the above forecast into production.

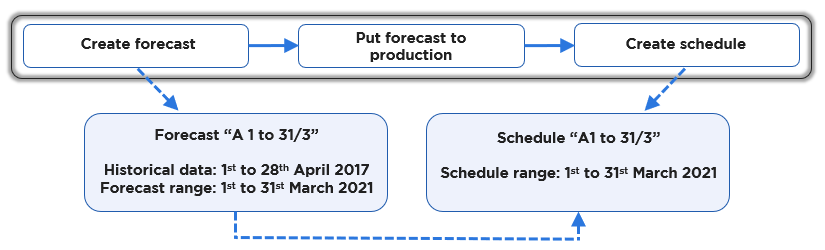

  3. Create a schedule “A 1 to 31/3” assigning work to agents serving Queue A from 1st to 31st March 2021 using the production forecast “A 1 to 31/3”.

Scenario B: Multiple forecasts for a single schedule, partial overwrites

Task: Create a single schedule using a forecast partially overwritten with a fresh forecast containing more recent data.

Solution:

  1. Create a forecast “B 1 to 31/3” for Queue B for 1st to 31st March 2021 using historical data from 1st to 28th April 2017 and save it as a draft.

  2. Put the above forecast into production.

  3. On receipt of new information, create forecast “B 15 to 31/3 for Queue B for the 15th to the 31st March 2021 using historical data from 1st to 28th March 2019. This forecast contains shrinkage increased to 20%.

  4. Put the above forecast into production – forecast “B 15 to 31/3” will overwrite forecast “B 1 to 31/3” for the 15th March onwards.

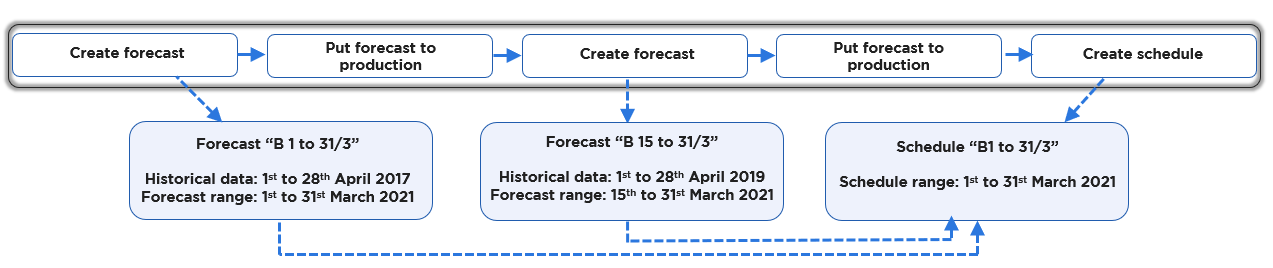

  5. Create schedule “B 1 to 31/3” covering the dates 1st to 31st March 2021. This schedule will use forecast “B 1 to 31/3” to cover the dates 1st to 14th of March 2021, and the forecast “B 15 to 31/3” to cover the dates 15th to 31st.

Scenario C: Multiple forecasts for a single schedule, multi-skill/channel

Task: Create a single schedule for voice and email work using parallel forecasts for voice and email.

Solution:

  1. Create forecast CV 1 to 31/3 for queue C-Voice for 1st to 31st March 2021 using historical data from the queue C-Voice for 1st to 28th April 2019.

  2. Put the above forecast into production.

  3. Create forecast CM 1 to 31/3 for queue C-Mail for 1st to 31st March 2021 using historical data from the queue C-Mail for 1st to 28th April 2019.

  4. Put the above forecast into production

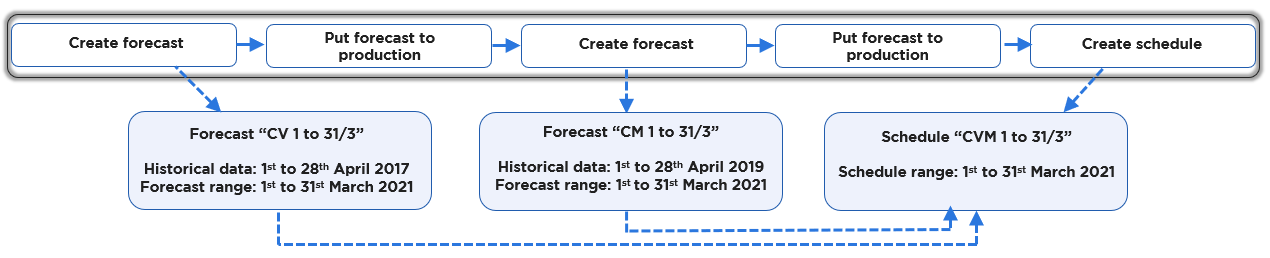

  5. Create schedule CMV 1 to 31/3 selecting queue C-Voice and C-Mail to cover the dates 1st to 31st March 2021.


The following scenarios illustrate common use cases of the draft and production forecasts and schedules. Click on the links below to expand the examples.

Scenario 1: Selecting production schedules for particular months

The scheduling manager needs to prepare a schedule for Q1 2020. It is planned that from February a group of interns can be included in the schedule. There must be two separate schedules prepared – one for staff only and a second which includes also interns.

Step 1: The manager creates a draft forecast for the period from January through March.

Step 2: The manager creates a production forecast based on the draft forecast.

Step 3: The manager adds a new draft schedule for January only. Then, the manager will add a second schedule for February and March. Interns can be included in the second schedule.

Step 4: The first schedule will be selected as a production schedule in January, the second schedule will be selected as a production schedule in February and March.

Scenario 2: Sharing tasks by preparing several production schedules

There are two scheduling managers in the call center. They need to prepare a schedule for the next six months. They agree to divide the work: one manager will create a schedule for the first three months and the second manager for the next three months. Both managers can work independently on the draft schedules whenever they have time, even concurrently. The draft schedules can be applied to the production schedule at any time.
